New Building
Construction Pictures

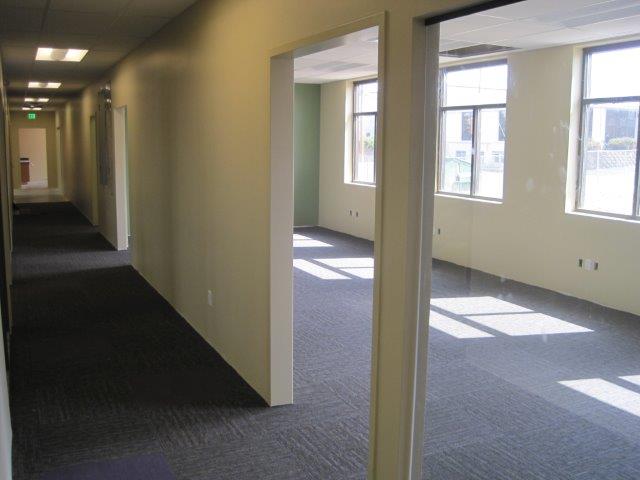

The Building Is Complete!

View
the
Project Video by Bob Powers

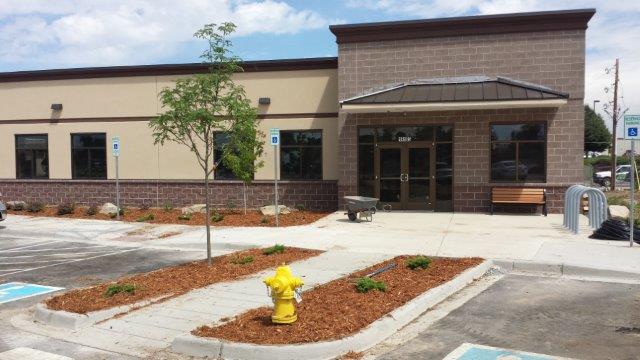

July 30, 2015

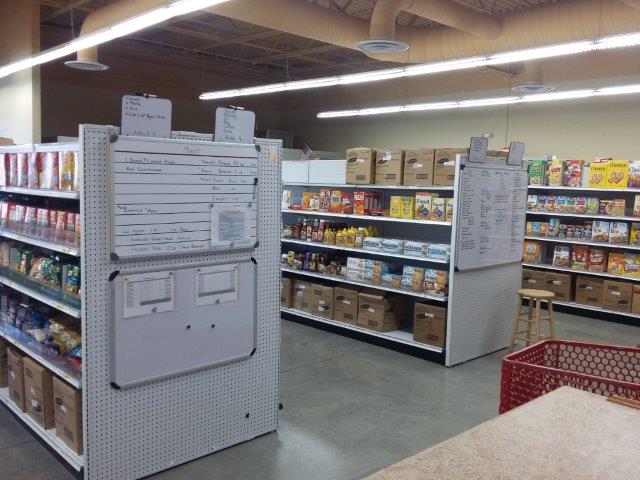

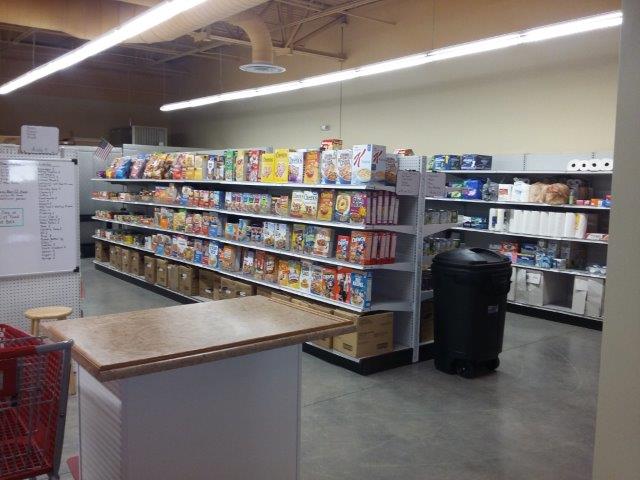

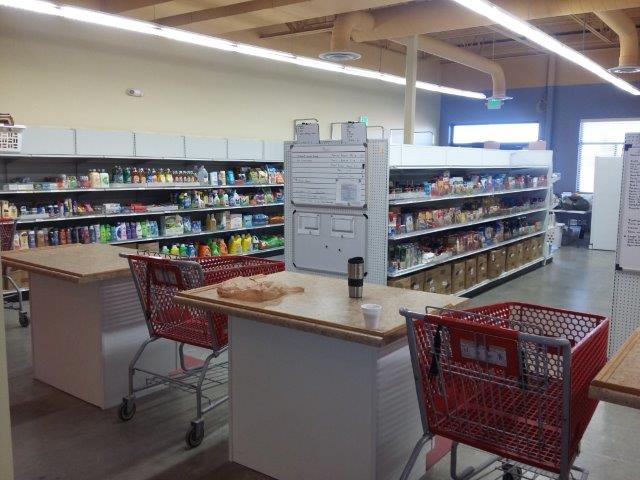

The building is complete! Landscaping is complete! We should have
our Certificate of Occupancy by the end of this week. Thanks to the
generous donated effort of several

Lowes employees we have most of
the shelving installed for the new shopping room and several new

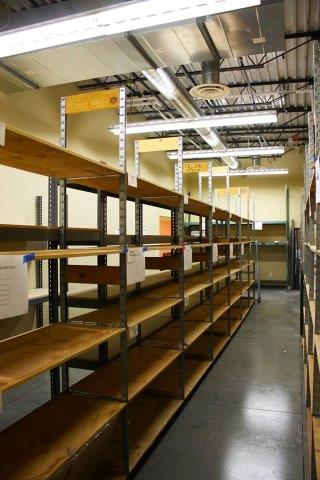

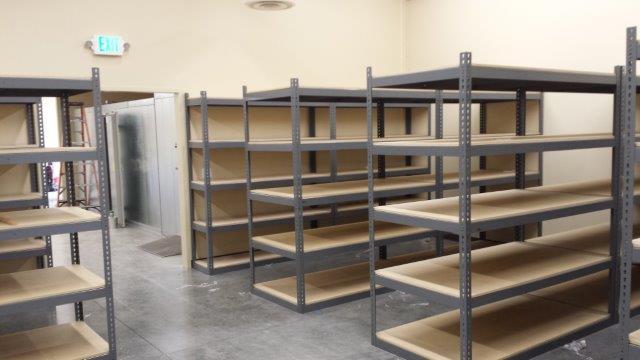

desks assembled. Most of the general storage shelving has also been
installed. Many years in the making and it's here!

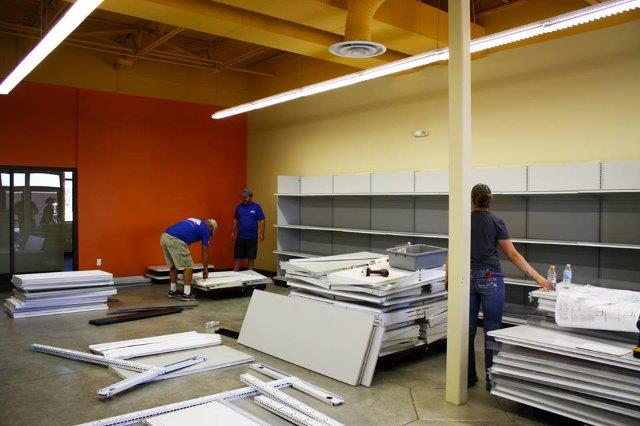

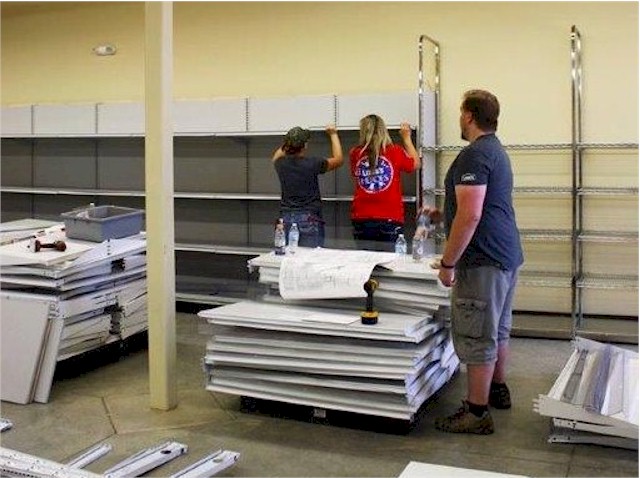

Volunteers From Lowes
Installing Fixtures

Volunteers From Lowes
Installing Fixtures

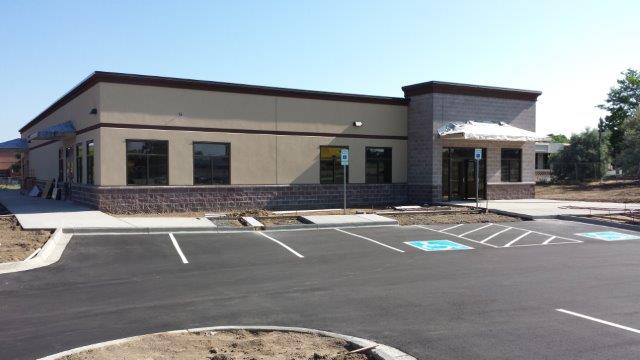

July 22, 2015

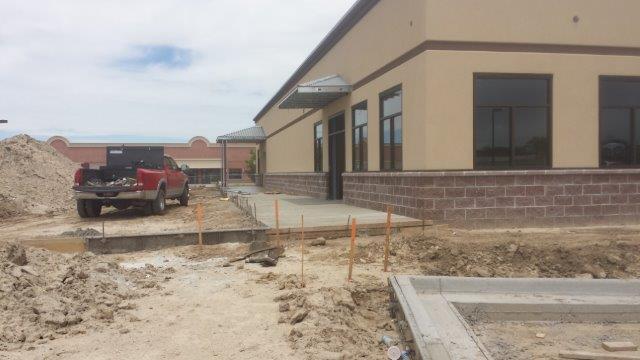

Landscaping is nearing completion. All of the utilities are on.
The storage area shelves are installed. We're down to clean up
time.

July 13, 2015
Carpeting is complete, landscaping has begun and the
electricity is on. Interior touch up work and minor exterior finish
work should complete this week. Then it's on to final cleanup and
inspections.

July 03, 2015
Parking lot has been striped. Interior concrete floors have been
sealed. Carpet and landscaping will start next week.

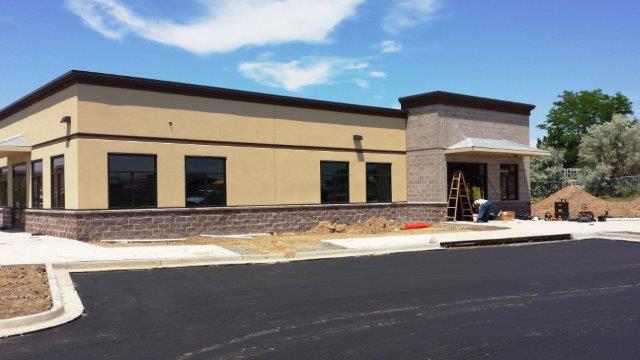

June 25, 2015

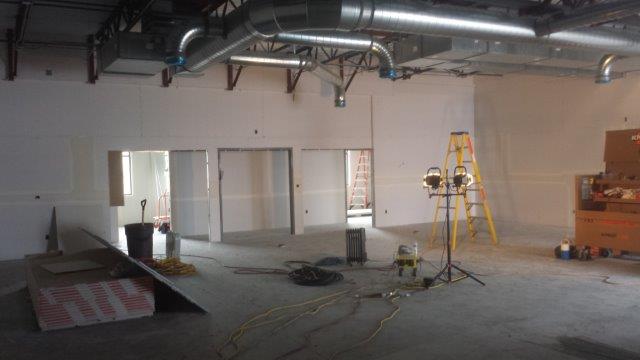

Interior finish work including drop ceiling, lights and final coat
of paint are about complete. Parking lot paving has begun.
Landscaping will be coming soon.

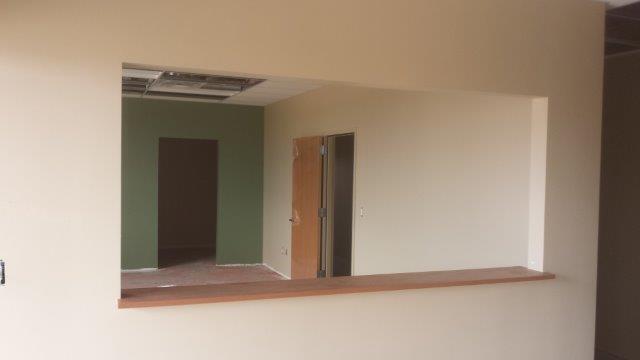

June 16, 2015
Continuing to make progress on parking lot curbs and sidewalks.
Asphalt may begin next week.
Progressing also on interior finish work such as cabinetry, doors,
and drop ceiling.

June 11, 2015

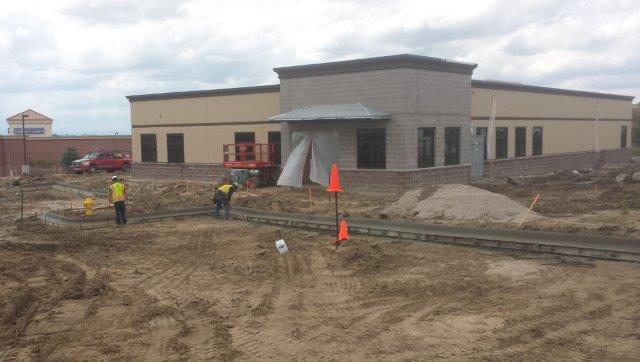

Curbs for parking lot finally going in. Interior is just a couple
of weeks away from completion. Parking lot and then landscaping
takes us to the finish line. Food Bank soon to come!

June 3, 2015

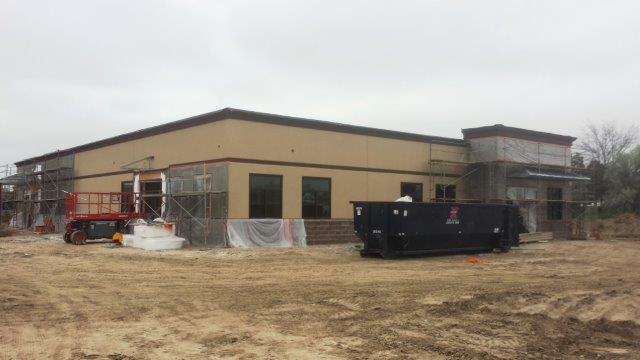

Exterior building finish work is under way. Interior painting as
well as bathrooms are nearing completion. Sidewalks and parking lot
paving should begin soon.

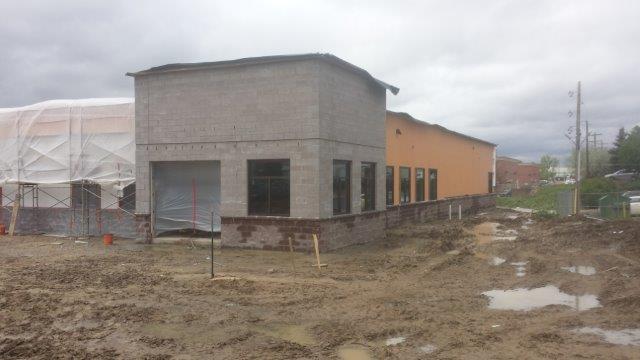

May 20, 2015

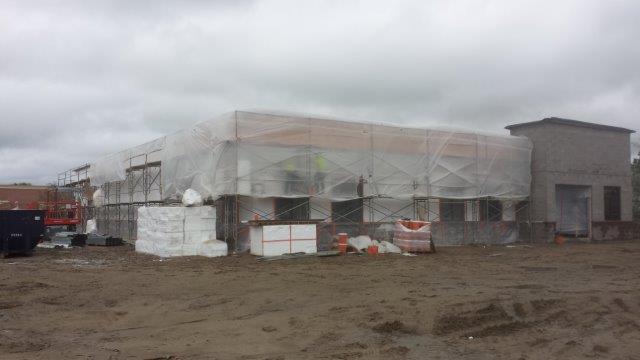

Exterior brick work is complete and exterior insulation is going on.
Interior dry wall is almost complete and painting might begin this
week. The walk-in cooler and freezer units are scheduled to be
delivered this week and work will begin to install those. Work
should also begin this week on bathroom tile. Efforts to place
curbs, sidewalks and paving will begin as soon as weather permits.

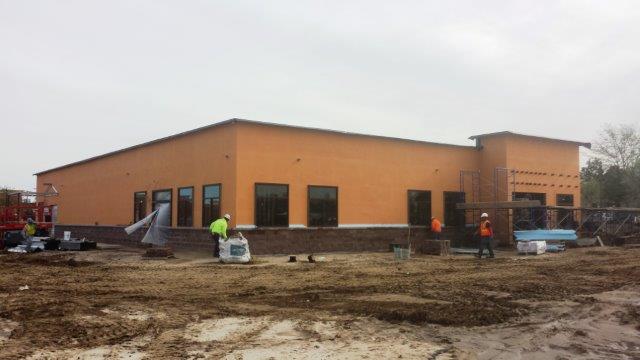

May 12, 2015

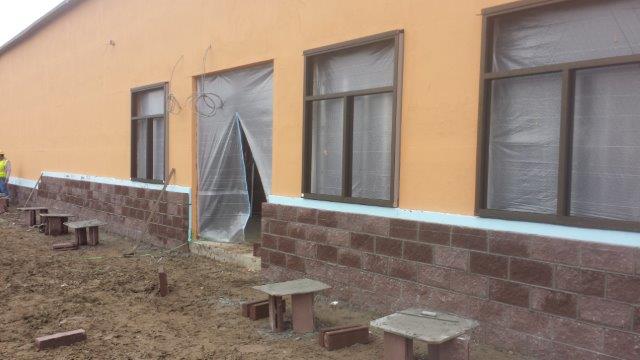

Brick
work is continuing. The windows are complete and drywall has
started. Exterior insulation should begin this week.

May 6, 2015

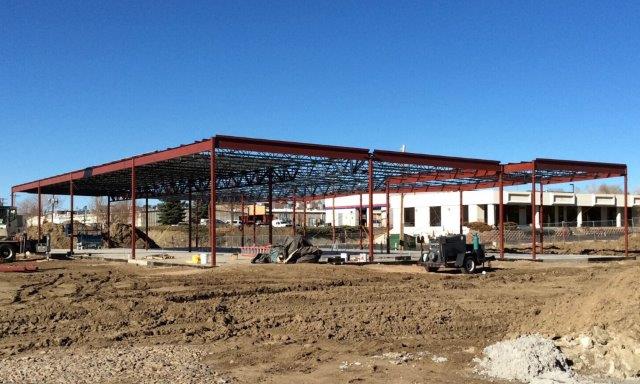

Interior wall framing is complete. Exterior brick work has begun.
Interior dry wall should begin this week along with windows and
interior wall insulation.

April 22, 2015

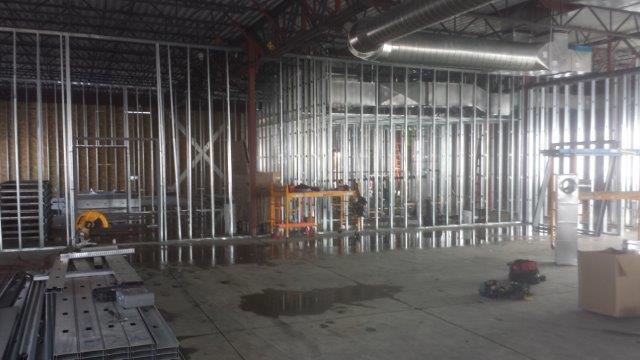

Roof top mechanical units have been placed. Interior wall framing
has begun. The start of a new shopping room!!!
April 15, 2015

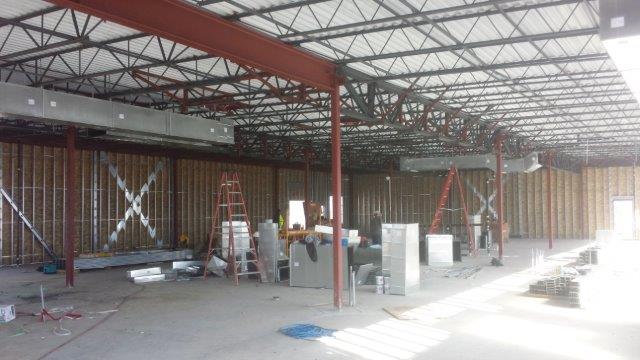

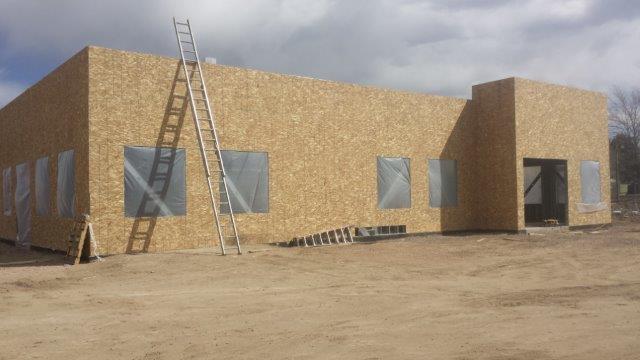

Exterior sheathing will be completed this week. Interior duct work
has begun. Placing rooftop mechanical units will begin next week.

April 7, 2015

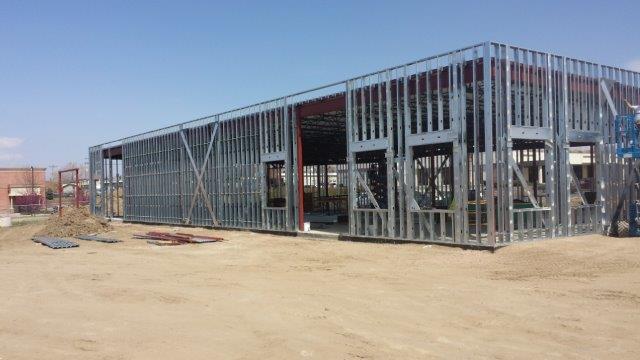

Exterior wall framing is complete. Electric service is being
brought in this week. Exterior wall sheathing will begin this week
also.

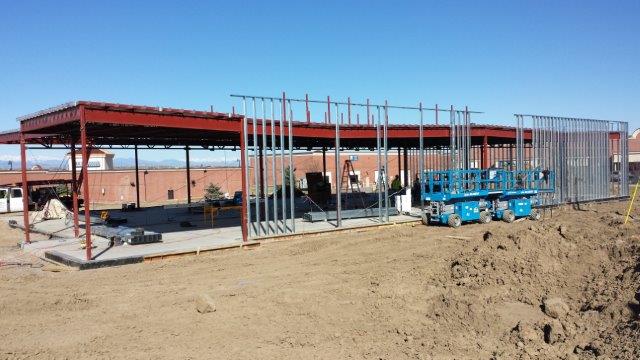

March 31, 2015
Roof decking is complete. Framing for exterior walls is under way.

March 24, 2015
Roofing is under way. Water taps have been completed. Exterior
walls still planned to start before end of March.

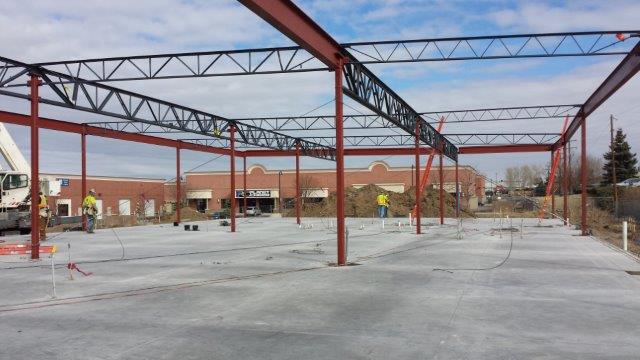

March 17, 2015
Structural supports are almost done. Roof will be going on this
week. Framing for exterior walls will begin before end of March.

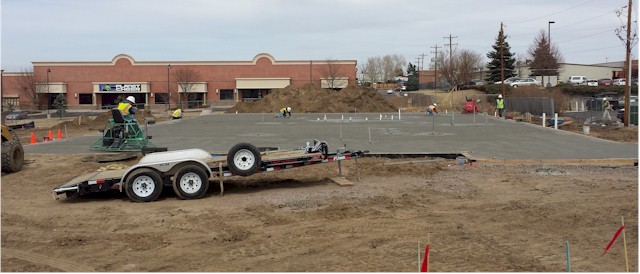

March 12, 2015
The concrete slab is poured. We have a floor!!
Structural steel should start to go up next week. We should start
seeing walls go up in April.

March 5, 2015

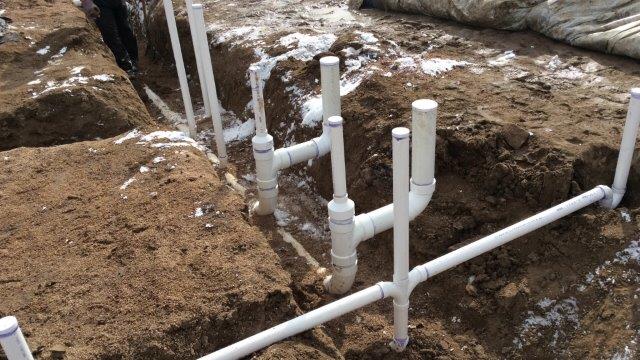

Some of the rough-in plumbing in preparation for pouring the slab
floor. Slab should be poured next week.

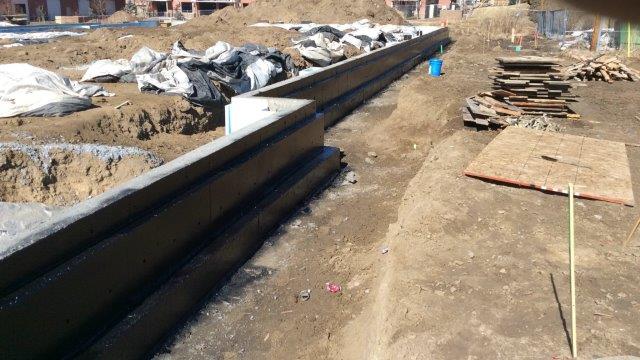

Feb 19, 2015
The
basic foundation is done.

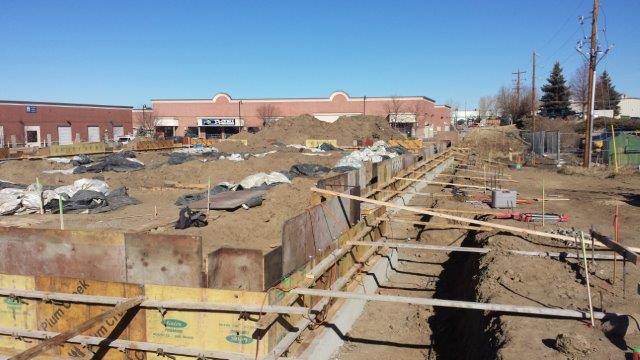

Feb 13, 2015
The building footings began to be formed in early February with a
target to have the concrete slab poured by the end of February.
March should see installation of structural support elements and
the beginnings of the roof.

Jan 26, 2015
This week they are working on bringing in the
underground utilities.

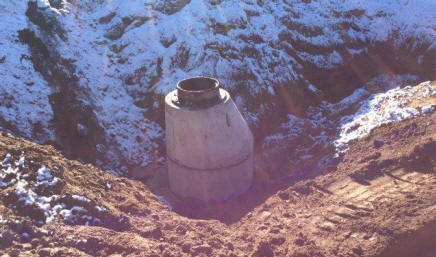

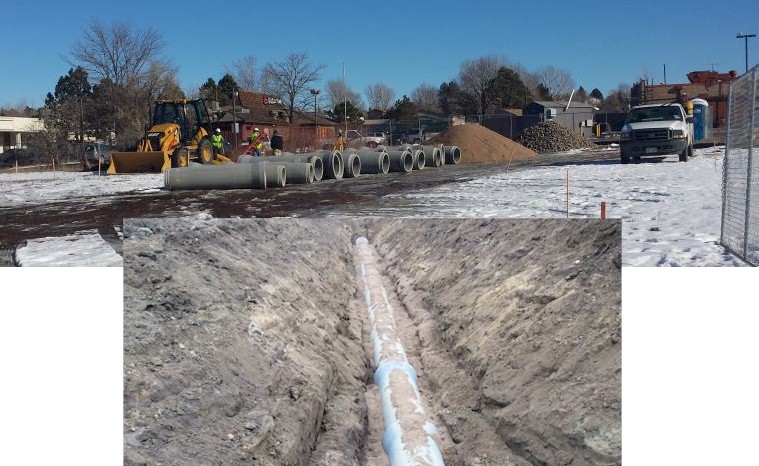

Jan 8th, 2015
The first phase began when drainage pipe sections were
delivered on site and erosion control steps were in place. Once the
grading and drainage phase is complete, efforts will begin on the
building foundation.

Nov 21, 2014
The soft ground
breaking was held on Friday, November 21st at 2:00 p.m.

More Ground Breaking
